Commercial Case Study

Clayton Homes - Warehouse Painting Project

Ready to make a change?

Schedule an Estimate

commercial painters on lift

CHALLENGES:

  • Due to the scale of the warehouse and it’s 27 foot ceilings, special equipment like scissor lifts were necessary to work along the ceilings, walls, and beams.
  • The large warehouse had over 1000+ red couplings and sprinklers needing to be masked off to stay up to code with the fire department.
  • The warehouse would need to accommodate the storage of incoming equipment and stock items during the ongoing project.

CONDITIONS:

  • Rusting I-Beams.
  • Grime, dust, and scuff covered ceilings, walls, and beams.

PROJECT INVOLVEMENT:

    • Prep
    • Remove dust from all ceilings, walls, and beams utilizing brooms, mops, commercial blowers, and shop vacuums.
    • Sand down rust where present and use rust inhibiting primer.

  • Paint
  • Coat the wall space, ceiling decking, structural steel I-Beams, bay doors, man doors, safety railing and one eyewash station.

PROJECT TIMELINE

Started: November 2019
Duration: Nov 20th – Dec 9th (20 Days)

“Friendly, efficient, and responsive to all questions we asked. Overall, the process from start to finish was very fluid.”

- Clayton Homes | Morristown, TN

Clayton Homes | Morristown, TN

Get a Free EstimateBack

Clayton Homes – Warehouse Painting Project

Sitting at 180,000 square feet, Clayton Homes recently purchased a manufacturing facility in Morristown, TN that needed an immediate facelift. The CertaPro Painting team planned to begin working in an empty warehouse but knew equipment and stock items would be introduced as the weeks progressed. In order to complete the project efficiently, the production team worked with Clayton to discuss which areas needed to be completed quickly, in order to house the materials.

Before Photos

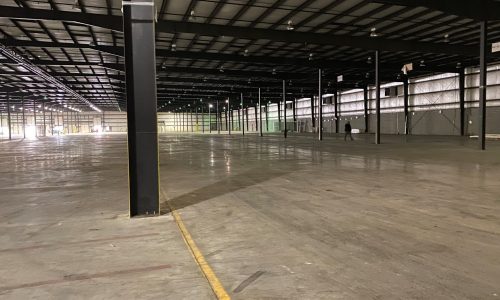

The Warehouse Before

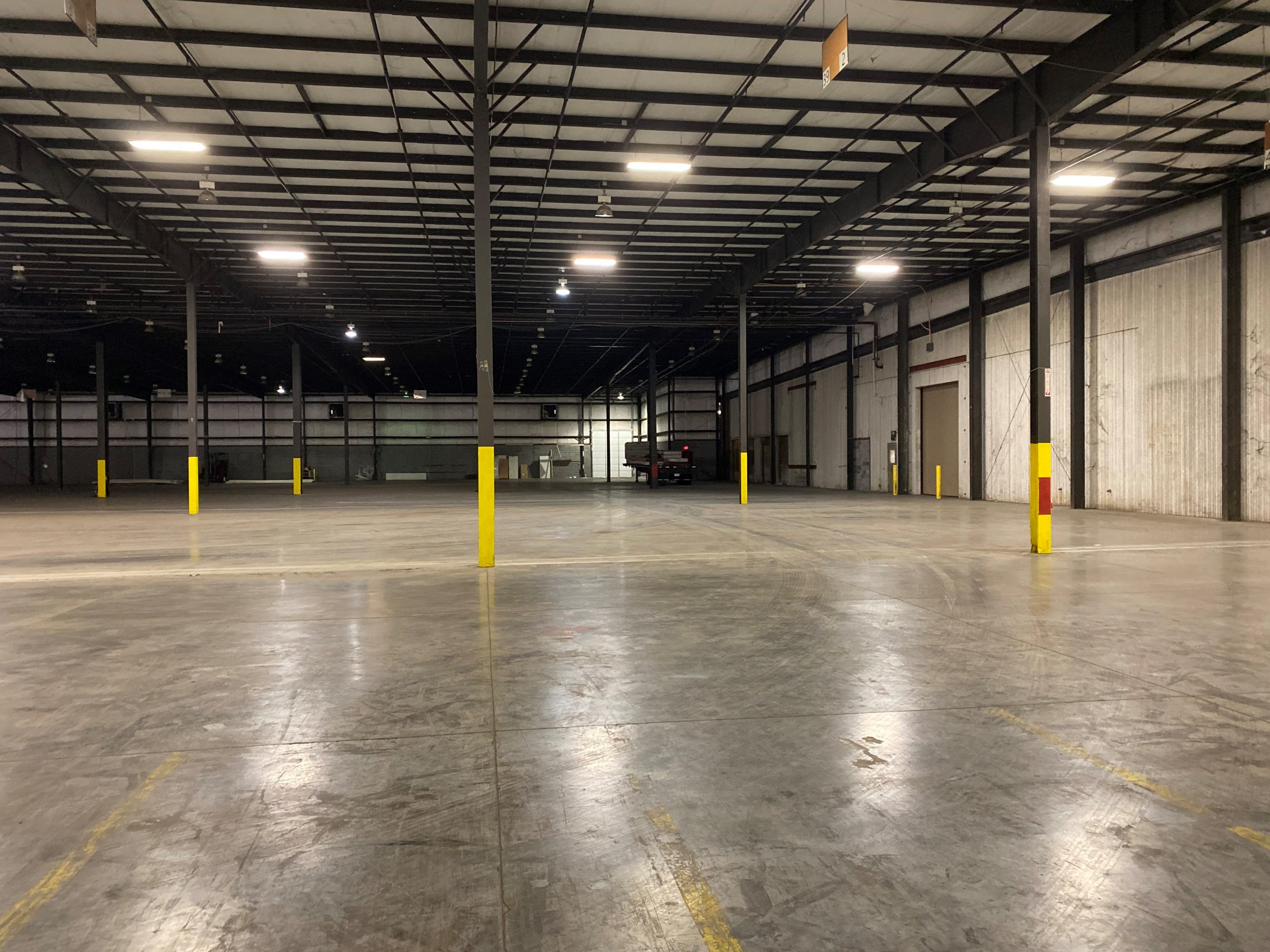

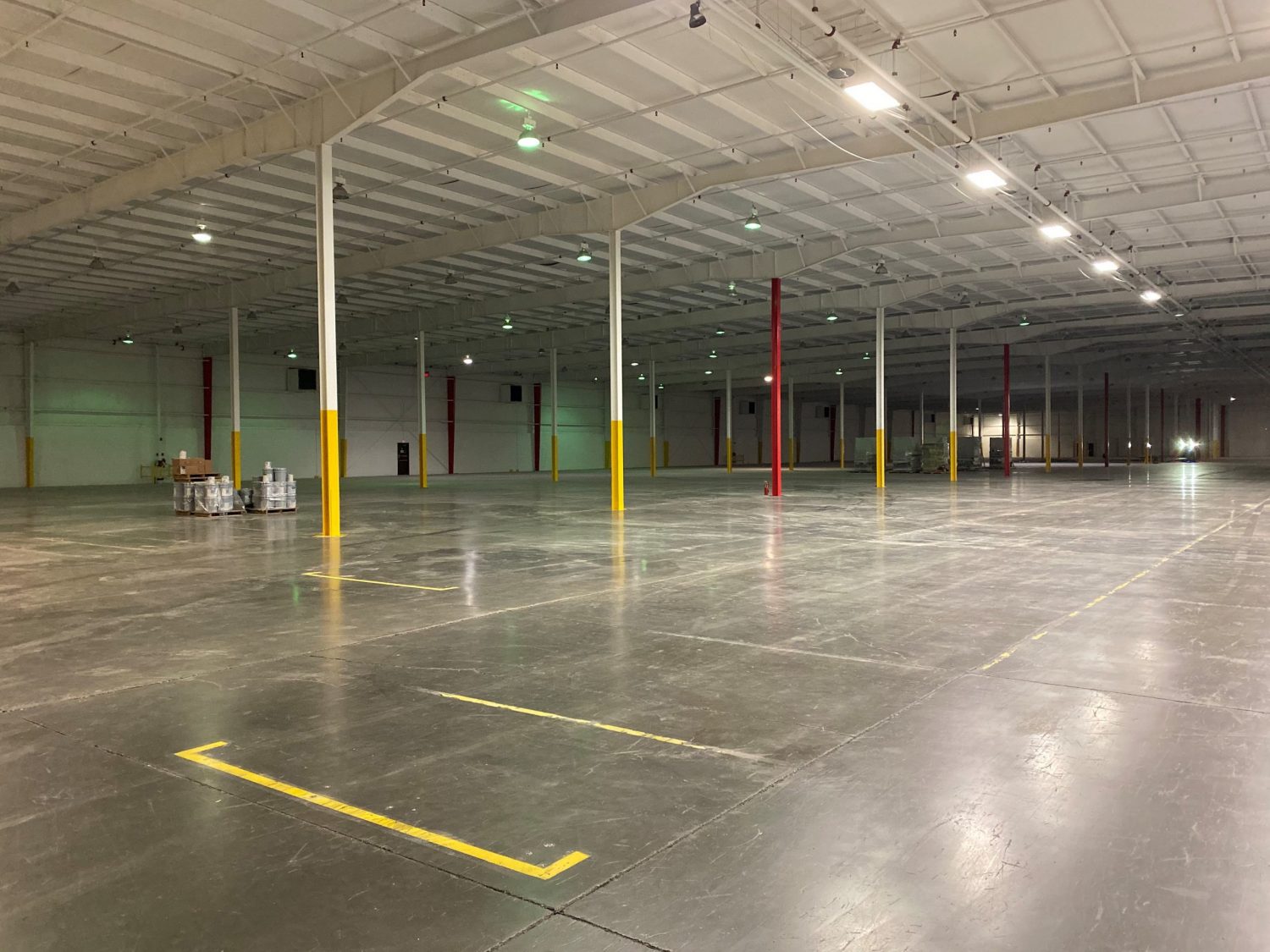

The Warehouse Before

The 180,000 square feet of warehouse before preparations begin.

Equipment Accommodations

Equipment Accommodations

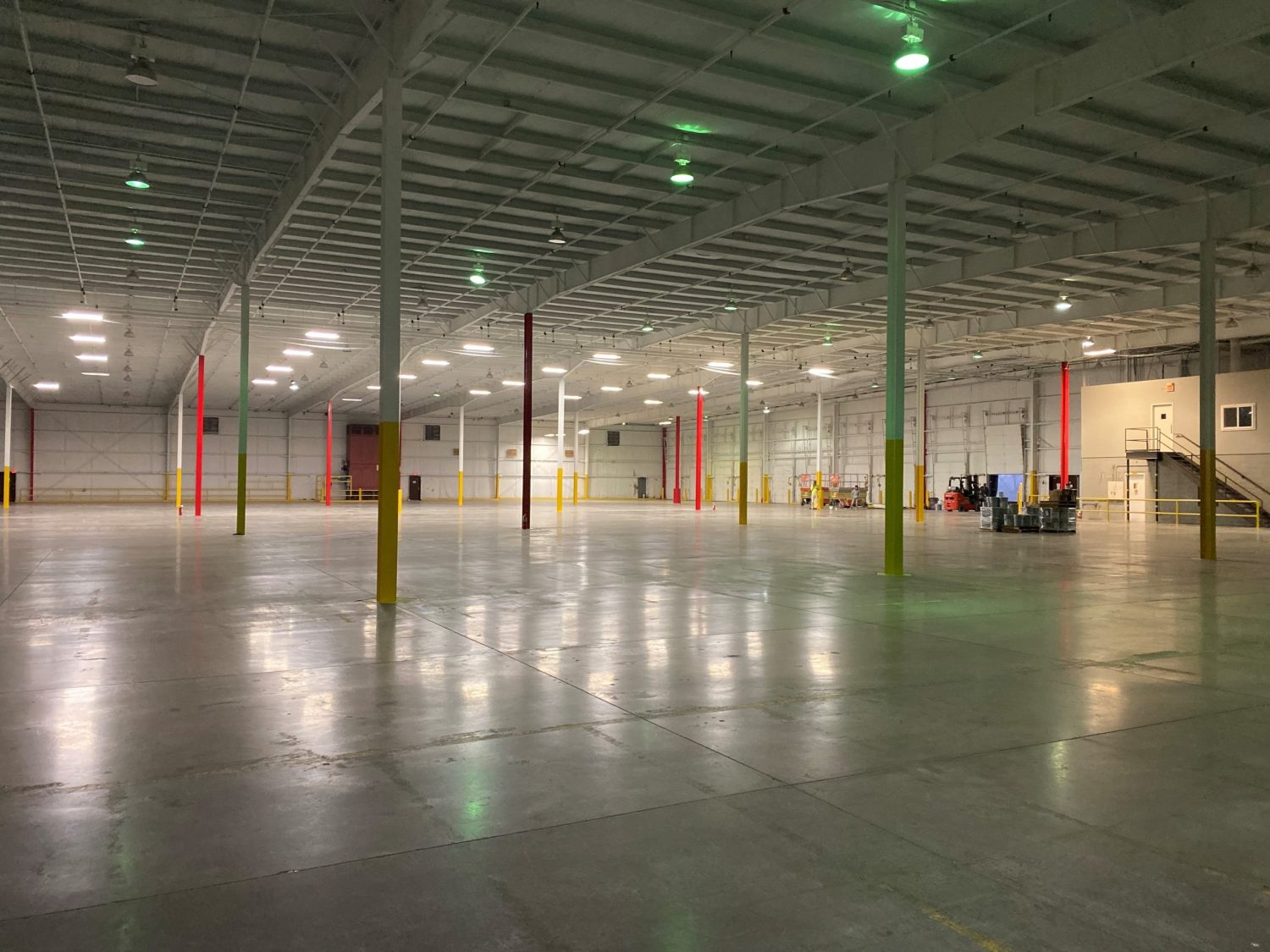

Various pieces of equipment that would need to be stored during the painting project included machinery like forklifts.

Rusted I-Beams

Rusted I-Beams

Rusted I-Beams before being sanded and having rust inhibiting primers applied.

Grimy Walls and Ceilings

Grimy Walls and Ceilings

Grime, scuffed, and dust covered walls and ceilings before being cleaned and prepped.

From dirt and debris, to cobwebs and uncoated surfaces, the CertaPro team knew this project would be an enormous undertaking from the start. Utilizing brooms, mops, commercial blowers, and multiple shop vacuums this dust was cleaned over the course of 8 days with up to 10 working crew members. Rust was limited on the I-Beams, but any severe rust was sanded, and spot treated with rust inhibitive primers. The ceiling sprinkler system had over 1,000 red couplings and sprinklers that had to be masked off to stay up to code with the fire department.

Work in Progress

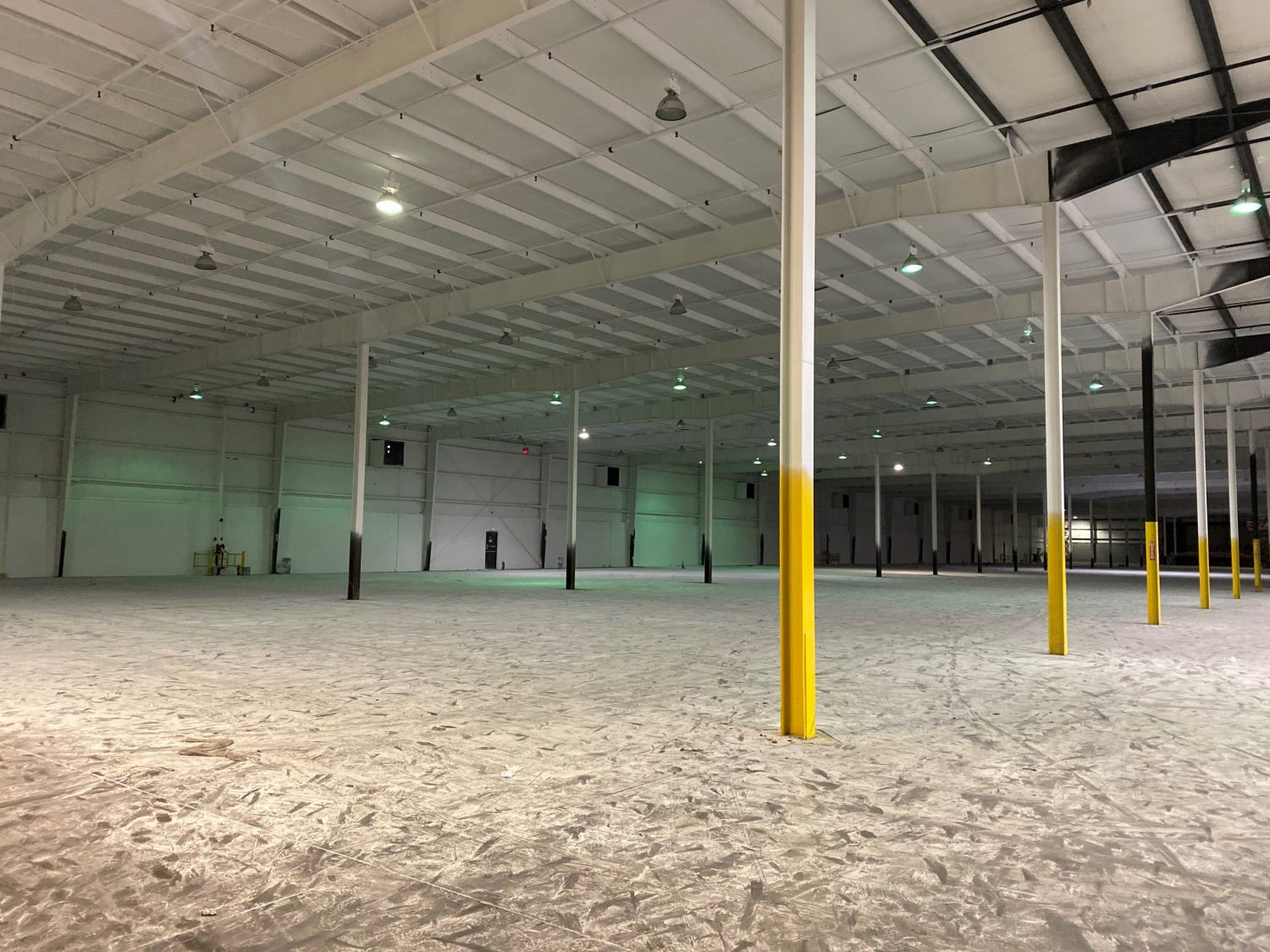

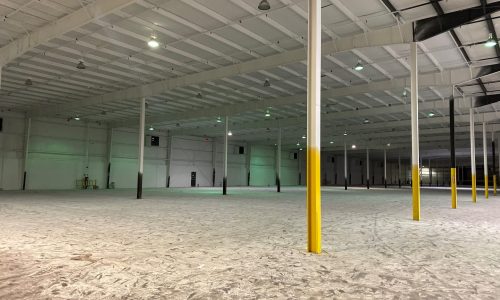

The Warehouse During

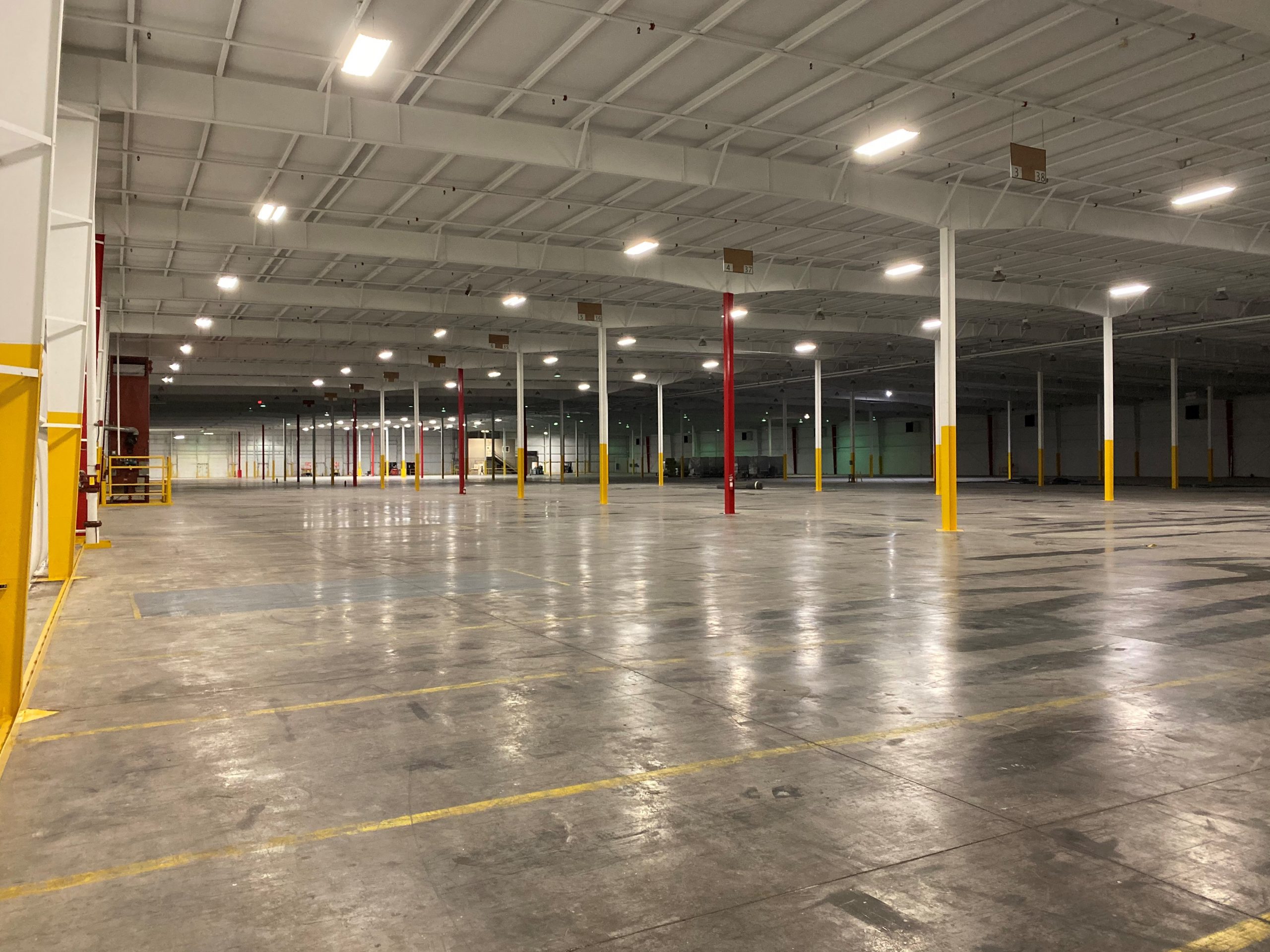

The Warehouse During

A large portion of the 180,000 square foot warehouse with painting underway.

Painting Begins

Painting Begins

With pre-paint preparations completed for this portion of the warehouse, painting efforts begin with the ceiling, walls, and I-beams.

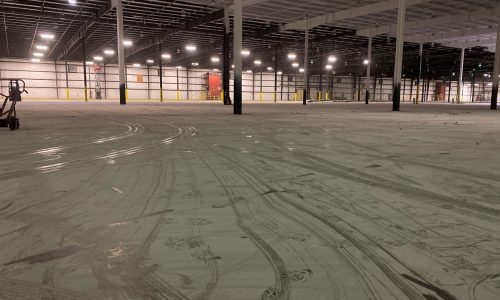

Preparing the next portion

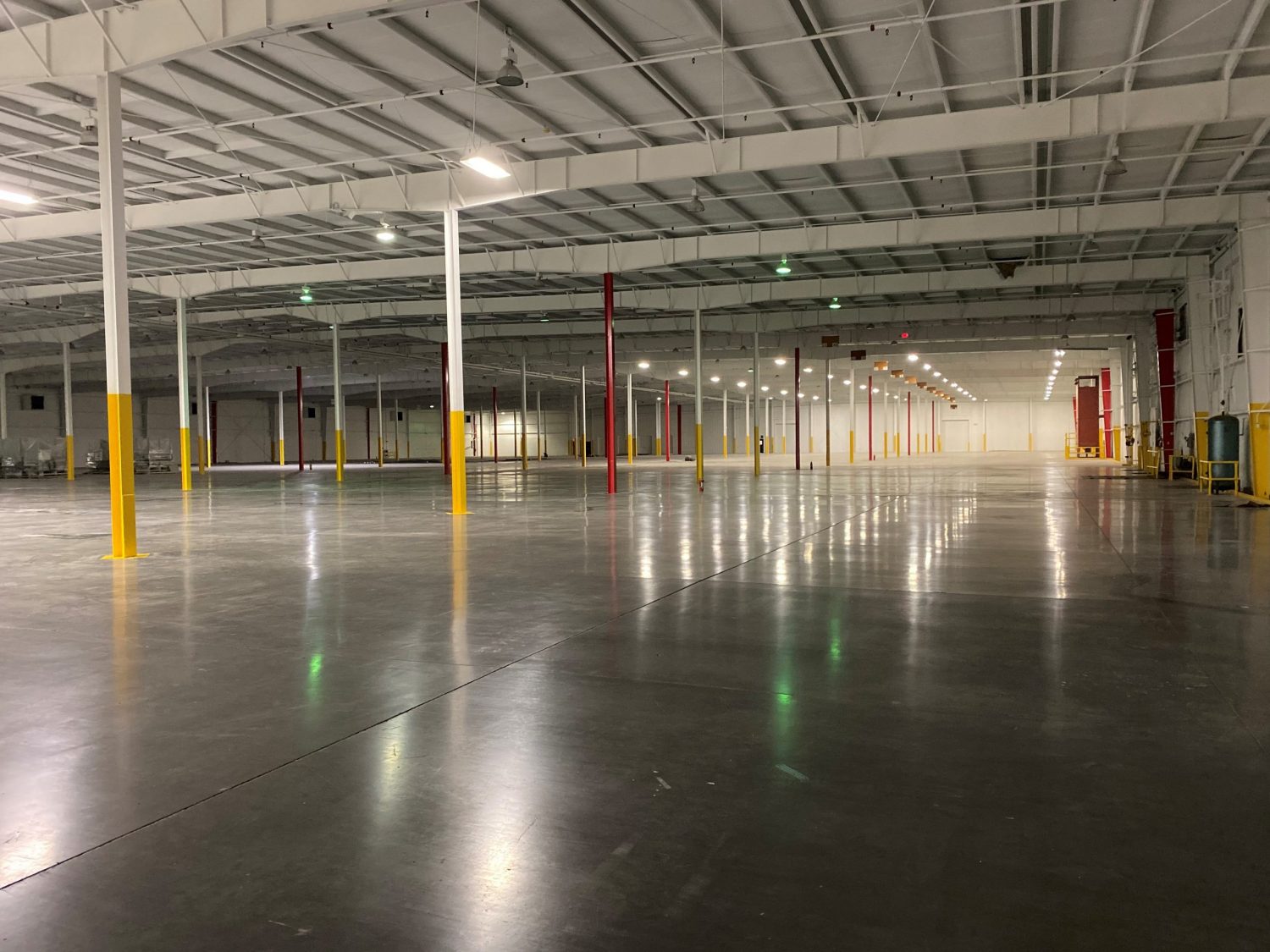

Preparing the next portion

The next portion of the warehouse to be painting is prepped.

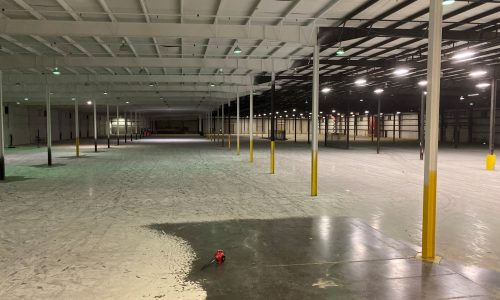

Completed portion being cleaned

Completed portion being cleaned

A fully painted area is cleaned with a blower to accommodate incoming warehouse materials.

Crews were tasked with coating the wall space, ceiling decking, structural steel I-Beams, bay doors, man doors, safety railing and one eyewash station. With 27’ ceilings, the Job Site Supervisor and crew utilized up to 8 scissor lifts with wide platforms to tackle the project in the most efficient manner. After 20 long days, the project was completed on December 9, 2019. When speaking with Clayton on their experience with CertaPro Painters, they noted that the crew was “friendly, efficient, and responsive to all questions we asked. Overall, the process from start to finish was very fluid.”

The Final Results

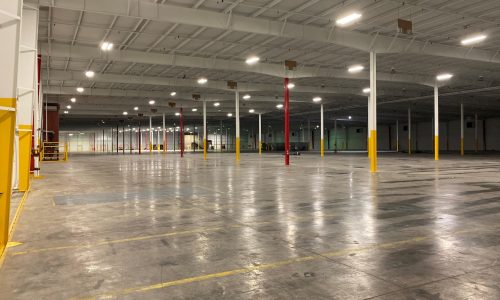

The Warehouse After

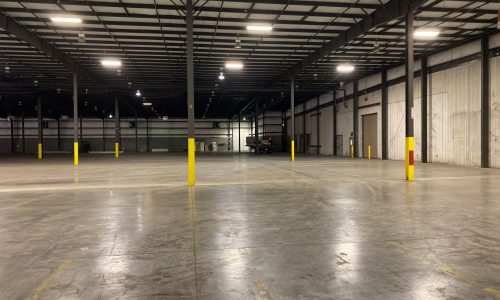

The Warehouse After

The completed warehouse painting project.

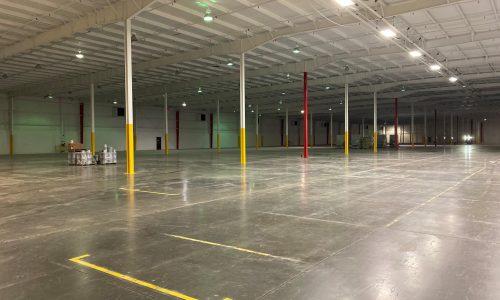

Fully Painted

Fully Painted

Final state of the painted ceilings, walls, beams and, doors.

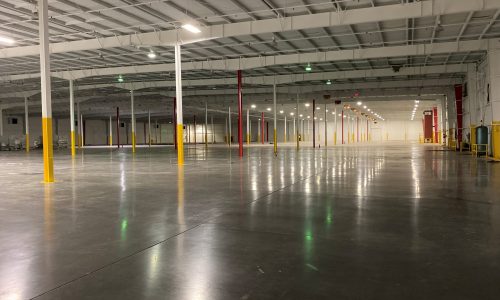

Cleaned Floors

Cleaned Floors

180,000 square feet of fully swept, blown, vacuumed and mopped floors after the painting project was complete.

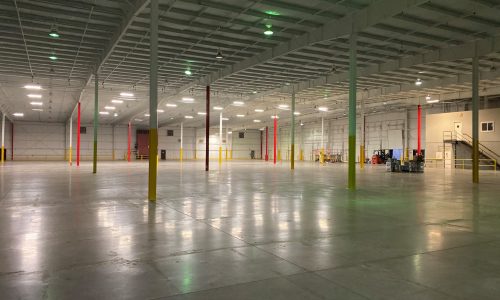

20 Days Later

20 Days Later

The last bit of painting equipment is being packed up to go.
